GOWGANDA SILVER TAILINGS
District-Scale Silver Tailings. Four Decades of Validated Metallurgy.
The Gowganda silver tailings represent approximately 2.96 million contained ounces of silver in a historical NI 43-101 Indicated resource, supported by four decades of independent drilling, metallurgical testing, and engineering work by firms including Watts Griffis & McOuat, Kilborn Limited, and GeoVector Management. Nord's January 2026 acquisition of four historic mining leases consolidated the principal tailings deposits and adjacent infrastructure under a single operator for the first time in the district's 116-year history.

REGIONAL CONTEXT
The Cobalt-Gowganda Silver District
The broader Cobalt-Gowganda district has produced over half a billion ounces of silver since 1903. The Cobalt Camp proper accounts for approximately 460 million ounces. The Gowganda satellite camp, 50 km to the west, contributed over 60 million ounces, principally from the Miller Lake O'Brien and Siscoe operations between 1910 and 1972.

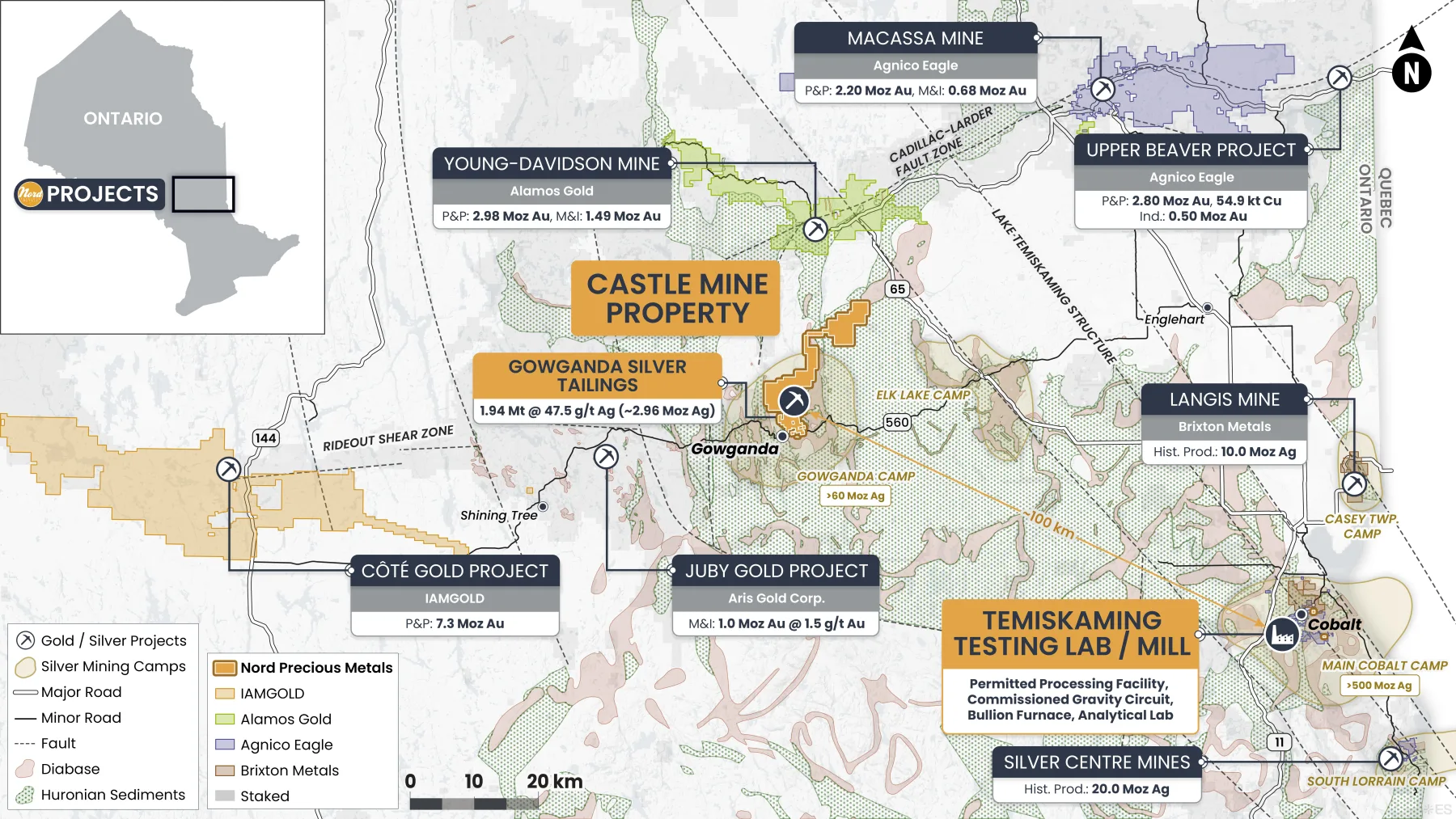

The Gowganda tailings sit adjacent to Nord's Castle Mine property, approximately 100 km west of TTL Laboratories in the town of Cobalt. The surrounding region hosts Agnico Eagle's Macassa and Upper Beaver projects, Alamos Gold's Young-Davidson mine, and IAMGOLD's Côté Gold, placing Nord's silver assets within one of northeastern Ontario's most actively mined corridors.

TECHNICAL WORK
Four Decades of Drilling, Sampling, and Engineering
The Gowganda tailings have been the subject of sustained independent investigation since 1981. Each successive program was conducted by a different firm, and each confirmed the resource and the metallurgy. The consistency of silver recovery results — 82% (1981), 85%+ (1987), 80%+ (2007) — across different firms, methods, and decades provides meaningful confidence in the deposit's processing characteristics.
1981
Watts, Griffis & McOuat
545 auger + 26 drive pipe holes (1,570 m).
~1.7M tons at 1.45 oz/t Ag, 82% recovery.
Cyanide leach, Lakefield Research.
1987
Kilborn Limited feasibility study
152 sonic holes (910 m). 1,000 TPD seasonal leach designed.
85%+ recovery, IRR to 49.3% at US $12/oz Ag.
Canadian Mining Hall of Fame firm; acquired by SNC-Lavalin, 1996.
2000
Sandy K Mines sonic drill program
32 holes in the core area.
Average 2.0 oz/t Ag, 40% above deposit mean.
Concluded earlier resource underestimated by 25%+.
2011
Temex Resources / GeoVector
Metsolve thiosulfate testwork; 764 holes (3,012 m) integrated.
Indicated 1.94M t at 47.5 g/t Ag = 2.96M oz.
80%+ non-cyanide silver recovery confirmed.
2026
Nord / GeoVector MRE update
860+ holes incl. 103 BMR sonic with multi-element sampling.
Consolidated land package.
Updated estimate expected H2 2026.
KILBORN 1987 FEASIBILITY
Historic Economics at Modelled Silver Prices
Kilborn Limited's 1987 feasibility study designed a 1,000 TPD seasonal leach operation with 85%+ silver recovery, a seven-year production schedule yielding approximately 2 million recoverable ounces, and financial projections across a silver-price range of US $6 to $12 per ounce. The study was prepared with contributions from Witteck Development Inc. (metallurgy), SENES Consultants Limited (environment), and Markham Data Incorporated (financial analysis). The full report is publicly available through the Ontario Geological Survey.
At Kilborn's top case of US $12, the projected internal rate of return was 49.3%. Silver today trades above US $78.
Kilborn 1987 high case
IRR at modelled US $12/oz Ag
49.3%
Silver today
Approx. spot price, US$/oz
~$78
APRIL 1987
Kilborn Limited — 1,000 STPD Tails Remilling Project Feasibility Study
Source: Kilborn Limited, 1,000 STPD Tails Remilling Project Feasibility Study, April 1987 (at US $4.7M capital cost). Historical projections are for informational purposes only. No current economic study has been completed.
GEOVECTOR 2011 RESOURCE
Indicated Resource Holds Steady Across a Wide Cutoff Range

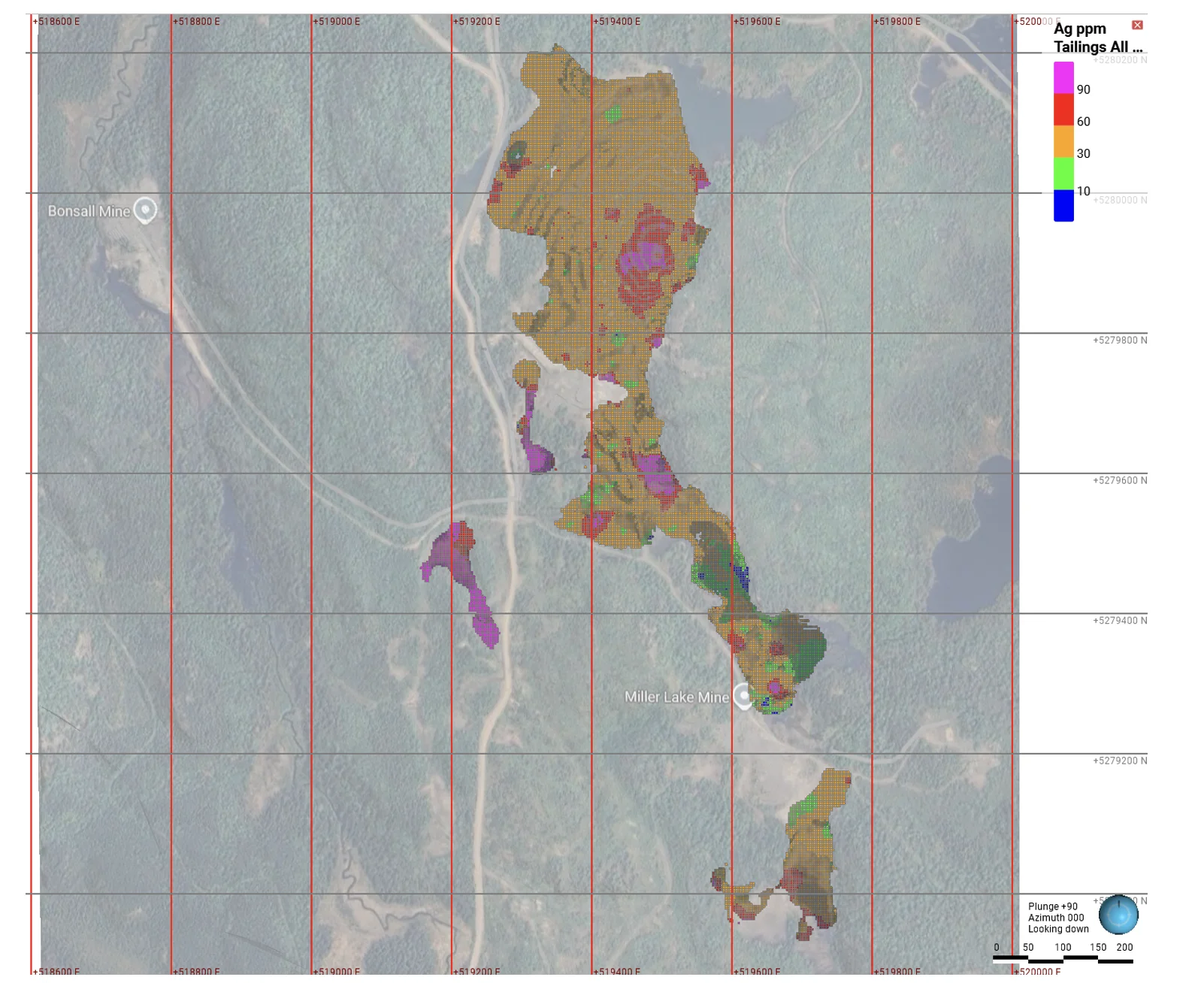

GeoVector Management's 2011 NI 43-101 resource estimate integrated 764 drill holes across three campaigns (1981, 1986–87, 2000) into a block model using inverse distance squared interpolation. The Indicated tonnage and contained silver ounces hold nearly flat from a 5 g/t cutoff up to 20 g/t — a signature of a well-distributed, homogeneous deposit with a tight grade distribution and few high-grade outliers.
Indicated mineral resource (10 g/t Ag cutoff)
Tonnage: 1.94 million tonnes
Grade: 47.5 g/t silver
Contained silver: approximately 2.96 million ounces
JULY 2011
GeoVector / Temex Resources — NI 43-101 Technical Report on the Gowganda Silver Property
Source: GeoVector Management Inc., NI 43-101 Technical Report, July 8, 2011 (Table 4), Indicated Mineral Resource category. Historical estimate; the Company is not treating it as a current mineral resource under NI 43-101 unless reaffirmed by a qualified person.
ACQUIRED LEASES & GEOLOGY
Past Producers Within a Single Contiguous Land Package

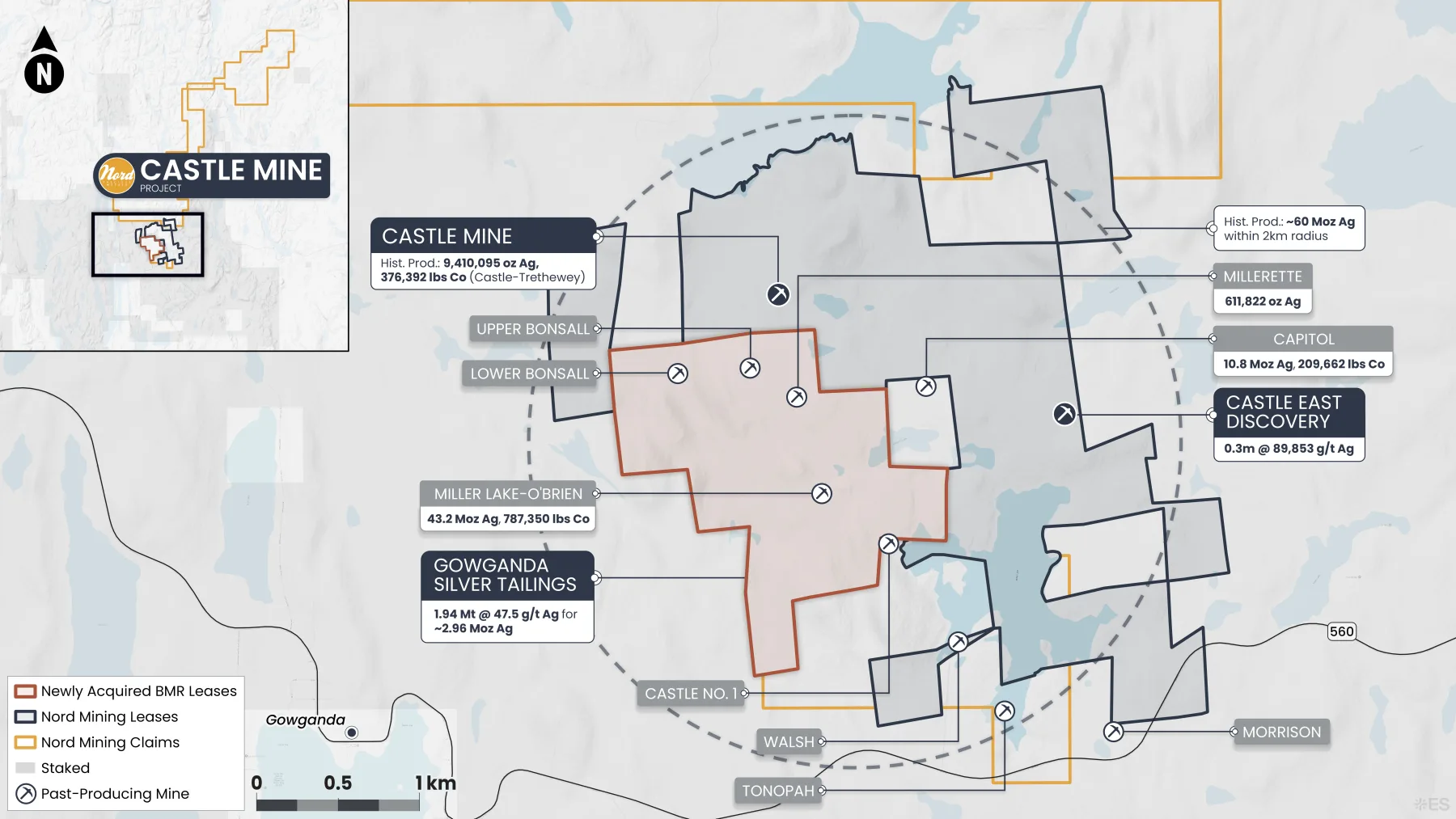

The newly acquired BMR leases consolidate four historic past producers — including Miller Lake-O'Brien, Millerett, and Bonsall — onto a single contiguous land package adjacent to Nord's existing Castle Mine and Castle East discovery. All deposits are hosted in the same Nipissing diabase-hosted, native-silver vein system that defines the broader Cobalt-Gowganda camp.

PAST PRODUCTION
Combined historical output exceeds 53 million ounces of silver

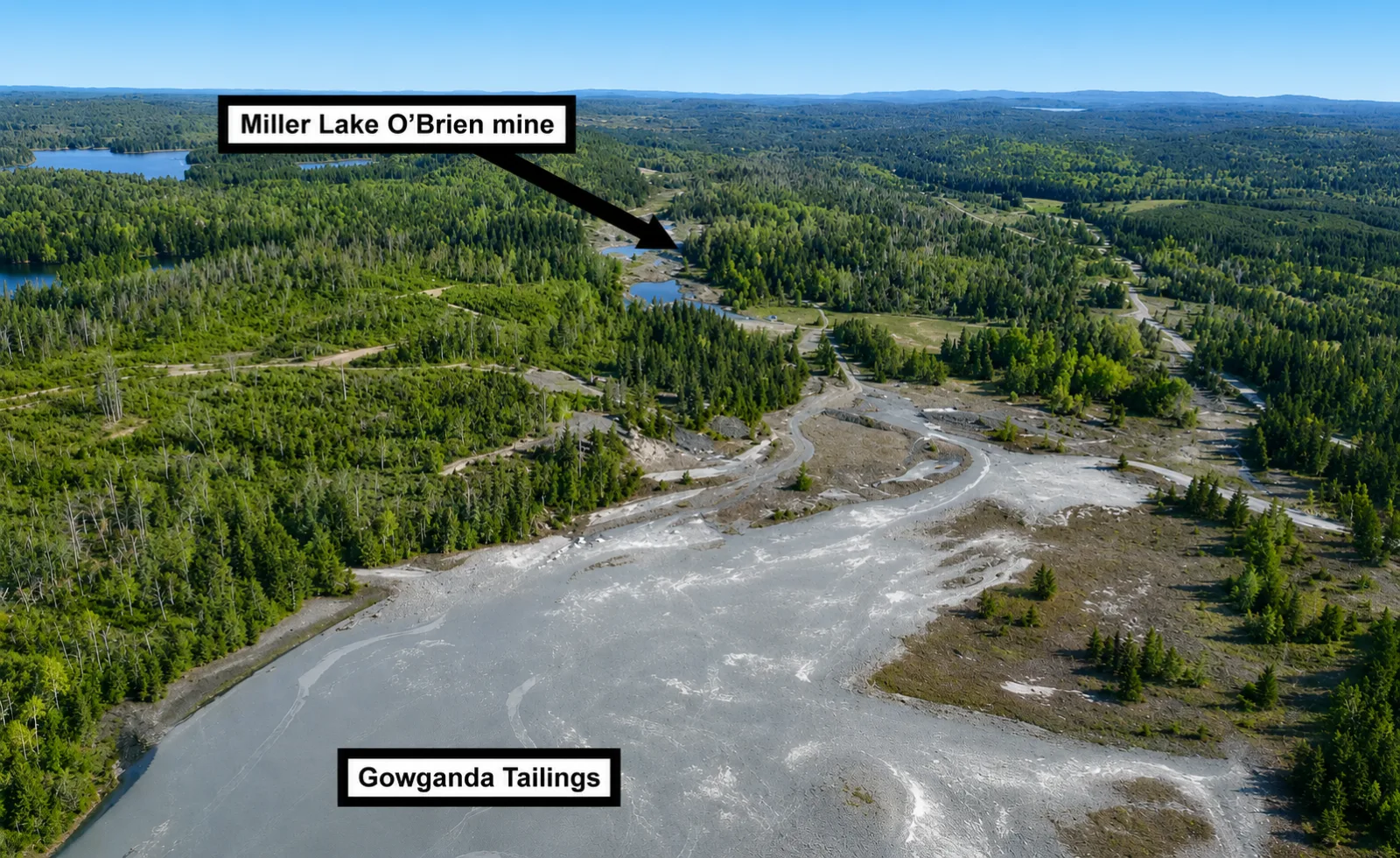

Across four contiguous past producers now under Nord's control — Castle-Trethewey, Miller Lake-O'Brien, Millerette, and Bonsall — historical silver production exceeds 53 million ounces. For the first time in the district's history, this production base sits under a single operator, with proximate access to Nord's Castle Mine workings, the Temiskaming Testing Lab in Cobalt, and the Company's planned 600 TPD modular gravity plant — creating one consolidated platform for the next round of resource definition and recovery work.
Miller Lake-O'Brien (oz Ag)
Castle-Trethewey (oz Ag)
Millerette (oz Ag)
Bonsall (oz Ag)
Historical production figures compiled from Ontario Geological Survey and operator records. Historical production is not indicative of any current mineral resource or reserve.
PROCESSING STRATEGY
Processing Architecture: Leach Plant and District Infrastructure
The Gowganda tailings require a hydrometallurgical processing route. Four independent metallurgical test programmes conducted between 1981 and 2007 have confirmed silver recoveries of 80–85% through cyanide leaching (WGM / Lakefield, 1981; Kilborn / Witteck, 1987) and through thiosulfate leaching (Temex / Metsolve, 2006–07), a non-cyanide alternative. Kilborn's 1987 feasibility study designed a 1,000 TPD seasonal cyanide leach plant with Merrill-Crowe recovery. These established processing baselines will inform the Company's evaluation of next steps once the updated GeoVector mineral resource estimate is complete.
The silver precipitate produced by the Merrill-Crowe process may be refined at the Company's TTL Laboratories facility in Cobalt, Ontario, which maintains furnace capacity for the production of silver doré. The solid leach residue from silver recovery is expected to contain recoverable quantities of cobalt, nickel, and other strategic metals in arsenide and sulfarsenide form. The Company has validated hydrometallurgical processing routes for arsenical concentrates through independent testwork programmes and intends to evaluate the residue as a potential secondary recovery stream.
District Processing Infrastructure
Beyond the Gowganda tailings, Nord maintains processing infrastructure that serves the broader Cobalt-Gowganda district. TTL Laboratories is the only permitted high-grade milling facility in the Cobalt Camp, operating gravity circuits, a furnace, and an assay laboratory. The Company's 600 TPD modular gravity plant awaits commissioning under the recovery permit framework.
These facilities are designed for feed sources where the silver mineralogy is amenable to gravity concentration. Testwork on Beaver Mine tailings has produced commercial-grade high-grade silver concentrate via gravity recovery (October 6, 2025 press release), confirming that certain district tailings and waste rock streams can be processed through existing equipment. Historical underground workings across the consolidated property also contain broken ore material in stopes that was never hoisted to surface. This material, if quantified through sampling, would represent an additional gravity-amenable feed source.
The phased approach — gravity processing of amenable district materials through existing infrastructure, concurrent with development of a purpose-built leach facility for the Gowganda tailings — allows the Company to advance toward production on multiple fronts while each processing route serves the feed source for which it is metallurgically suited.
PATH FORWARD
Next Steps
Expected H2 2026
Updated Mineral Resource Estimate
GeoVector Management has been retained with two of three original QP authors and all original modelling data. The update will integrate 860+ drill holes across the consolidated land package.
Permitting
Recovery Permit
Advancing under Ontario's 80-day fast-track framework. Specialist permitting consultants and T-Engineering (environmental compliance and paste backfill engineering) are engaged. The Ontario Ministry of Mines has provided an advanced template and confirmed the regulatory pathway.
Underway
Confirmatory Metallurgical Testwork
Tailings samples have been collected. Testwork is underway to confirm the 1987 Kilborn and 2007 Temex / Metsolve metallurgical results under current standards and to evaluate both cyanide and thiosulfate processing routes.
Post-MRE
Advancing the project to its next phase
Following completion of the updated mineral resource estimate, the Company plans to advance the Gowganda Silver Tailings to its next phase of project work, drawing on Kilborn's 1987 engineering baseline and benchmarking against current silver prices and operating conditions.
KEY DOCUMENTS
Technical References
SEDAR+ • JULY 2011
NI 43-101 Technical Report — GeoVector / Temex Resources
Ontario Geological Survey • APRIL 1987
Kilborn Limited — 1,000 STPD Tails Remilling Project Feasibility Study
